How Much Did NASA’s Nancy Grace Roman Space Telescope Cost?
Published on | Written by Alec Pow
This article was researched using 11 sources. See our methodology and corrections policy.

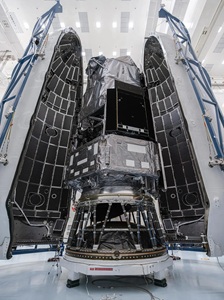

NASA’s newest flagship astrophysics observatory began its trip to deep space on August 30, 2026, after launching successfully aboard a SpaceX Falcon Heavy from Kennedy Space Center. NASA says the spacecraft is now traveling toward the Sun-Earth L2 region for commissioning before science operations begin. The launch occurred at 7:26 a.m. EDT.
The best current answer is $4.316 billion. That is NASA’s lifecycle cost commitment, not merely the price of the telescope hardware. GAO confirmed in July 2026 that Roman remained within its $4.316 billion replanned lifecycle commitment as launch approached.
The money covers development, flight hardware, the Coronagraph technology demonstration, integration and testing, launch, ground systems, and the five-year primary science mission. Some of that spending occurs after launch, so $4.316 billion should not be described as cash NASA had already spent by August 30.
Roman is best priced as a full NASA mission rather than a piece of spacecraft hardware. Development scope, instruments, contractor changes, launch services, science operations, and mission duration determine which cost figure answers a particular question.
How Much Did NASA’s Nancy Grace Roman Space Telescope Cost?
Jump to sections
Roman carries a $4.316 billion (at $30 per hour, earning that amount would take about 69 thousand years of full-time work, before taxes) lifecycle commitment, including about $255 million for launch services and hundreds of millions more in major instrument, contractor, and science-operations work.
Important numbers
- Current lifecycle commitment at $4.316 billion
- Original maximum lifecycle baseline at $3.934 billion
- COVID-related replan increase at $382 million
- Falcon Heavy launch-services contract at about $255 million
- Combined BAE Systems and L3Harris contract value at $681 million as of the 2024 NASA OIG audit

NASA’s $4.316 billion figure
Roman’s headline number is a lifecycle commitment. It combines the years spent designing, engineering, assembling, testing, launching, commissioning, and operating the mission rather than assigning one purchase price to the finished spacecraft. Roman carries a 2.4-meter primary mirror, a Wide Field Instrument built for large infrared surveys, spacecraft systems, communications hardware, solar power, thermal systems, ground infrastructure, and the Coronagraph Instrument technology demonstration.
The five-year primary science mission is also included in the approved cost boundary. This is why describing Roman as a $4.316 billion (about 69 thousand years of full-time work at $30 per hour) telescope can be useful shorthand but remains incomplete accounting language. The physical observatory is only one part of what NASA bought. The agency also paid contractors and science institutions to design hardware, process data, build ground systems, support launch and commissioning, archive observations, and operate the mission after it reached space. Roman’s accounting structure is closer to a full NASA mission-cost calculation than to the retail-style hardware pricing used for a commercial satellite.
The launch was only one slice. Roman will spend months commissioning its systems, followed by years of planned science activity, which means part of the approved mission cost remains tied to post-launch work.
Roman vs Webb and Hubble spending
Roman is expensive even by spacecraft standards, but it is far below the development scale reached by the James Webb Space Telescope. NASA’s 2018 Webb replan placed that mission’s lifecycle estimate at $9.66 billion. Roman’s $4.316 billion (about 69 thousand years of full-time work at $30 per hour) commitment equals about 44.7% of that figure. Using the rounded $10 billion Webb figure often cited after launch puts Roman at roughly 43%.
Historical Hubble accounting runs in the opposite direction. NASA OIG’s 2024 Roman audit compared a historical Hubble figure of $2.1 billion with Roman at about $4.3 billion and Webb at $10 billion. Roman is just over twice that cited Hubble amount.
The comparison needs a scope warning because Hubble launched in 1990 and later accumulated decades of operations, new instruments, and servicing missions. NASA now says Hubble’s inflation-adjusted mission spending since 1977 is much larger. The older $2.1 billion figure is useful for launch-era scale, not as a lifetime Hubble total. Readers can see another accounting angle in James Webb telescope spending.
$3.934 billion became $4.316 billion
NASA did not begin Roman with its current ceiling. When the mission moved into hardware development in March 2020, the agency set an expected development cost of $3.2 billion and a maximum lifecycle cost of $3.934 billion. That larger amount already included five years of operations and science plus the Coronagraph technology demonstration. The pandemic then disrupted suppliers, facilities, staffing, integration schedules, and contractor work.
The single worked calculation starts with that $3.934 billion maximum. NASA’s independently verified 2021 replan added $382 million due to pandemic effects. The math is $3.934 billion + $382 million = $4.316 billion. Dividing the increase by the original $3.934 billion baseline gives about 9.7% growth.
That calculation does not mean every internal cost increase came from COVID-19. Individual contractor agreements also changed because of requirements, underestimated work, supplier problems, and technical issues. The $382 million figure explains the formal mission-level replan that established the current commitment.
Observatory, Coronagraph, launch
NASA OIG separated Roman’s replanned cost into about $3.9093 billion for the Roman observatory and $406.7 million for the Coronagraph project. Those amounts sum to the $4.316 billion lifecycle commitment. The Coronagraph figure is not an extra charge above Roman’s total. It is one component inside that mission accounting boundary.
| Roman cost angle | Published amount | What it measures |
|---|---|---|
| Full lifecycle commitment | $4.316 billion | Development through primary operations |
| Roman observatory component | $3.9093 billion | Observatory side of OIG lifecycle accounting |
| Coronagraph project | $406.7 million | Technology-demonstration project accounting |
| Falcon Heavy launch service | About $255 million | Launch service and related mission costs |
NASA separately awarded SpaceX approximately $255 million for Falcon Heavy launch services and related mission costs. That equals about 5.9% of Roman’s lifecycle commitment. It should not be added again to $4.316 billion because launch is already part of the lifecycle scope.
Contractor growth
Two of Roman’s major industrial contracts show how costs can move sharply inside a mission that still remains under its top-level commitment. NASA OIG found that the combined BAE Systems and L3Harris agreements began at $309 million and later reached $681 million.
The increase was $372 million, equal to roughly 120% of the starting contract value. NASA-directed changes accounted for $219 million of that increase, with another $153 million classified as overruns. BAE Systems’ work included the Wide Field Instrument optical-mechanical assembly and related support.
L3Harris handled the Optical Telescope Assembly and associated flight hardware. NASA OIG said project reserves absorbed these increases without moving Roman beyond its lifecycle commitment. That distinction changes the answer.
A mission can remain within its approved top-level budget even when individual supplier contracts grow substantially because reserves were established for technical and programmatic risk. Contractor growth is still real spending pressure, but it is not automatically the same thing as a lifecycle overrun.
The $372 million increase alone is almost as large as the mission’s separate $382 million pandemic replan, even though the two figures describe different accounting events and should not be combined as duplicate cost growth.
Three Roman cost views
Lifecycle case. A taxpayer asking what NASA committed to spend on the full mission should use $4.316 billion. This captures development, the Coronagraph, launch, and the five-year primary mission. It is the strongest single answer to the broad cost question.
Launch case. A buyer comparing rocket services should use approximately $255 million. That amount prices the Falcon Heavy launch service and related mission work rather than the telescope, instruments, science operations, or years of development.
Operations case. A researcher looking at the institutions that turn Roman data into science will encounter much smaller contracts. NASA increased its Space Telescope Science Institute agreement by $166.25 million, producing a total contract value of $200.84 million through September 2027. NASA also awarded Caltech a separate $49 million Science Support Center contract. These figures are not substitutes for the mission total. They reveal specific pieces of the labor, data, and operations structure supporting Roman.
Post-launch work
Roman left Earth on August 30, but the accounting story did not stop at spacecraft separation. NASA expects a commissioning period before science operations, followed by a five-year primary mission. Ground teams must command the observatory, process and calibrate data, schedule observations, archive information, maintain science systems, and support researchers using Roman’s enormous survey output. NASA says Roman is designed to return about 1.4 terabytes of data per day once science operations are active.
A reader comparing Roman with an ordinary satellite project should account for this long operational tail. Scientific spacecraft do not become financially complete when the rocket clears the pad. Data systems, communications, science staffing, calibration, software, archives, and mission control remain active costs for years after launch.
What we verified
- Checked NASA and GAO records for the current $4.316 billion lifecycle commitment.
- Confirmed NASA’s original $3.934 billion maximum and later $382 million pandemic replan.
- Cross-referenced contractor growth against NASA OIG’s audit figures.
- Verified the successful August 30, 2026 launch and the separate $255 million launch-services contract.
Article Highlights
- Roman’s current NASA lifecycle commitment is $4.316 billion.
- The original maximum was $3.934 billion before a $382 million pandemic replan.
- NASA’s Falcon Heavy launch-services contract was about $255 million.
- BAE Systems and L3Harris contracts grew from $309 million to $681 million.
- Science-support contracts include totals of $200.84 million and $49 million.
- The full lifecycle figure includes spending that continues after launch.
Answers to Common Questions
Did the Roman Space Telescope cost $4.3 billion?
Yes. NASA’s precise replanned lifecycle commitment is $4.316 billion, commonly rounded to $4.3 billion.
How much did it cost to launch Roman?
NASA awarded SpaceX an approximately $255 million launch-services contract covering Falcon Heavy launch service and related mission costs.
How much did Roman’s budget increase?
The formal lifecycle commitment increased by $382 million, from $3.934 billion to $4.316 billion, following NASA’s pandemic replan.
Was Roman cheaper than the James Webb Space Telescope?
Yes on the cited lifecycle figures. Roman’s $4.316 billion commitment is less than half of Webb’s roughly $9.66 billion to $10 billion mission figure, although the telescopes have different designs, histories, and accounting periods.
