,

How Much Does a US Navy Aircraft Carrier Cost?

Published on | Prices Last Reviewed for Freshness: January 2026
Written by Alec Pow - Economic & Pricing Investigator | Content Reviewed by CFA Alexander Popinker

Educational content; not financial advice. Prices are estimates; confirm current rates, fees, taxes, and terms with providers or official sources.

New nuclear supercarriers are multibillion-dollar warships, bought over many years and supported for decades, so the true bill spans acquisition, mid-life refueling, modernization, and day-to-day operations. This guide pulls together documented figures, shows what drives the range, and compares US carriers with allied ships to put the numbers in context.

Buyers here are taxpayers and policymakers, and their questions are practical. How much does one carrier cost to build today. How do lifetime upgrades push the total higher. What expenses hide outside the headline number, from the air wing to the escort ships and pier upgrades. This article lays out the best available public data and gives you a realistic sense of scale.

You will see current unit prices, real program examples, an itemized cost breakdown, factors that push budgets up, alternatives smaller navies choose, and a clear checklist for managing total cost of ownership. Costs add up. Plans change.

Article insights

  • New US supercarriers cost about $12–13+ billion to build, with then-year totals shaped by inflation, learning, and scope.
  • A mandated nuclear refueling adds ~$2.8–$3.0+ billion per ship mid-life.
  • A 2019 two-ship buy captured up to ~$4 billion in combined savings for CVN-80 and CVN-81.
  • CRS estimates Ford-class design changes save ~$4 billion in operating and support over 50 years versus Nimitz.
  • UK Queen Elizabeth-class cost £6.2 billion for two ships, highlighting a smaller, conventional alternative.
  • Budget presentations often exclude air wings, escorts, and refuelings, so procurement lines understate lifetime spend.

How Much Does a US Navy Aircraft Carrier Cost?

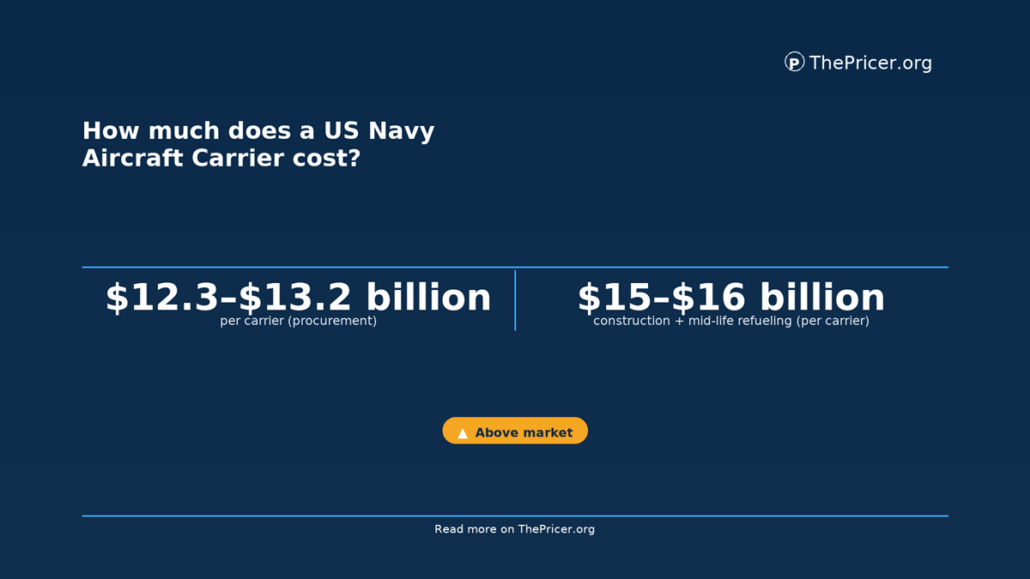

On procurement alone, the current US nuclear supercarrier, the Gerald R. Ford class, sits in the low-teens billions of dollars per ship in then-year dollars. The Congressional Research Service (CRS) places recent estimates for follow-on ships CVN-79 through CVN-81 around $12.3–$13.2 billion each depending on the fiscal year baseline and cap adjustments, noting the class aims for a smaller crew and lower 50-year operating costs than Nimitz-class predecessors.

Why the range. Ford-class ships are bought with incremental funding, so appropriations appear over six or more fiscal years, and each year’s “price” reflects updated inflation, shipyard learning curves, and changes to what counts under statutory cost caps. A 2019 two-ship purchase of CVN-80 and CVN-81 captured scale efficiencies that the Navy estimated at about $4.0 billion combined in then-year dollars.

Because carriers are procured with incremental funding over multiple fiscal years, the headline price often appears and reappears in budget documents, which can confuse casual readers about whether costs have increased or simply been re-phased across appropriations, and those optics can mask the impact of separate mid-life refuelings and post-delivery test costs that arrive far from keel-laying. The entire Ford-class program, encompassing multiple ships and associated costs, totals about $120 billion.

The National Interest further explains that these carriers are floating cities, equipped with nuclear reactors allowing decades of operation without refueling, and advanced systems such as the Electromagnetic Aircraft Launch System (EMALS) which increases sortie generation rates by 33% compared to previous classes.

Budget allocations for new carriers in 2025, including the USS John F. Kennedy (CVN 79), USS Enterprise (CVN 80), and USS Doris Miller (CVN 81), amount to billions annually, with individual ships reflecting a cost in the billion-dollar range each. As noted by Army Recognition, economies of scale through block-buy contracts have enabled savings estimated at around $4 billion for these vessels.

Real-Life Cost Examples

CVN-78 Gerald R. Ford, lead ship. CRS describes CVN-78 as a first-of-class program that introduced four critical systems, including the electromagnetic aircraft launch system and advanced arresting gear, and it documents cost growth relative to early caps, with a revised cap of $13.224 billion for the lead unit after successive NDAA updates. GAO’s testing oversight further shows these new technologies required extended shakedown and reliability improvements before full fleet introduction.

CVN-79 John F. Kennedy, follow-on. In recent budget submissions, CRS lists a follow-on unit procurement estimate in the ~$12–$13 billion band, reflecting learning from CVN-78 and production efficiencies that reduce rework but still carry inflation and supply-chain risk. The Navy’s FY2025 request included $236.0 million in that year’s procurement tranche for CVN-79 as part of its multi-year incremental funding profile.

Also read our articles on the cost of a B-2 Spirit Bomber, F-11 Fighter Jet, or F-35 Jet.

CVN-80/81 two-ship buy. The Navy’s 2019 two-carrier contract with Huntington Ingalls Industries captured “nearly $3–$4 billion” in combined savings versus baseline estimates, a rare case where buying more at once directly lowered unit outlays for a major combatant.

Mid-life refueling and complex overhaul (RCOH). Separately from new-build procurement, the US refuels each nuclear carrier around its mid-point. For reference, HII’s 2023-awarded RCOH for USS George Washington (CVN-73) was $2.847 billion, a figure that illustrates how a mandated life-extension event adds another large line item to the lifetime bill.

Cost Breakdown

Construction components. A carrier’s base price covers the hull and structure, nuclear propulsion plant and reactors, electrical generation, aviation facilities such as the flight deck and catapults, combat systems, and shipboard networks. Lead ships run higher because new systems require one-time engineering and integration. CRS notes Ford-class ships deliver more electrical power and sortie capacity with hundreds fewer sailors, trading upfront development for life-cycle savings.

Outfitting and shipboard systems. Beyond steel and reactors, cost drivers include radar and electronic warfare suites, aircraft launch and recovery systems, and aircraft handling equipment. The Government Accountability Office has repeatedly flagged electromagnetics and dual-band radar maturity as risk areas that added both time and money in the lead unit, reinforcing how first-of-class technology can bend the curve.

Labor, overhead, and management. A US supercarrier is built at one yard, Newport News Shipbuilding in Virginia, which means national capacity and workforce productivity directly shape cost. Dual-ship contracting, more predictable work, and infrastructure upgrades at the yard have been used to manage labor utilization and avoid idle periods, improving learning effects.

What is not in the base ship price. Procurement caps exclude costs like the embarked carrier air wing, much of the ship’s future modernization, and the escort ships and logistics tail of a carrier strike group. CRS also underlines that the Ford design targets around $4 billion in operating and support savings over 50 years per ship compared with the Nimitz class, which matters for lifetime planning even though it does not reduce the initial invoice.

Factors Influencing the Cost

Technology and R&D. New launch and recovery gear, advanced radars, and high-capacity power distribution raised non-recurring engineering on CVN-78 and created test-and-fix cycles. The payoff is lower crew count and higher electrical headroom for future sensors and weapons, but the effect on the lead ship budget was undeniable.

Labor and supply chain. Shipyard wage inflation, skilled trades availability, and vendor health ripple through the program. The Navy’s own documentation, as summarized in CRS, shows how schedule slips in one submarine or amphib program can collide with carrier work as yards juggle dry docks and skilled teams.

Macroeconomic shocks and policy. Pandemic-era disruptions, steel and component inflation, and congressional decisions on incremental funding windows can change cash flow and apparent then-year totals. CBO’s 2025 look at the shipbuilding plan reminds readers that headline hull numbers often exclude refuelings and other major support costs.

Cost controls. The two-ship buy for CVN-80 and CVN-81, infrastructure investments at the yard, and stable annual appropriations are the main levers the Navy has documented for pulling unit prices down. Savings are real but uneven, with larger gains on later hulls.

Historical Cost Trajectory

Real carrier prices did not just climb, they doubled over two generations of ships. Early Nimitz hulls in the 1970s and 1980s were procured for roughly $3.9–$4.5 billion per ship in then-year dollars, rising toward $6.2–$8.5 billion by the late 2000s as capabilities and labor rates increased. GAO’s 1995 and 1998 reviews anchor those early figures for CVN-76 and for class averages, while later estimates in constant 2012 dollars for the last Nimitz ships approach $8.5 billion, reflecting technology insertions and inflation across three decades.

The Gerald R. Ford class reset the baseline. CRS and Navy budget documents show CVN-78’s procurement settling at $13.3 billion in then-year dollars, with follow ships projected around $11–$12.5 billion due to learning-curve effects and multi-ship contracting. When converted to constant 2018–2024 dollars using official cost caps and budget exhibits, the Ford class sits in the $12–$13+ billion band per hull, even after accounting for planned savings versus Nimitz sustainment.

Inflation-adjusted comparisons clarify the curve. CRS’s long-running RS20643 series tracks per-ship caps and appropriations in successive budget years, making it possible to compare Nimitz late-life costs in constant dollars against Ford-class obligations. The picture is consistent across reports: a near-doubling of unit price from early Nimitz to Ford, with part of the delta explained by new systems like EMALS, AAG, Dual Band Radar replacements, and survivability upgrades that were not present on 1970s hulls.

CBO’s broader shipbuilding analyses add context. Real growth in naval ship costs has outpaced general inflation, driven by complexity, workforce constraints, and higher-end combat systems. That macro trend shows up in carriers most of all, which combine nuclear propulsion, high-capacity aviation systems, and dense electronics, pushing constant-dollar costs steadily upward between the two classes.

International Benchmarking

The United Kingdom’s Queen Elizabeth–class program delivered two 65,000-ton carriers for £6.2 billion combined, or roughly $7.5–$8.5 billion depending on exchange rate and year, per the UK National Audit Office and parliamentary documents. These are conventionally powered ships optimized for STOVL operations, which keeps cost lower than CATOBAR designs.

France’s Charles de Gaulle, commissioned in 2001, cost about €3 billion to build in 1990s euros, which equates to roughly $4–$5 billion today after inflation and currency conversion. It is a smaller nuclear carrier at around 42,500 tons displacement, reflecting a national strategy to field one nuclear flattop with catapults and arresting gear but at a reduced scale relative to U.S. supercarriers. The US is studying future approaches as allies weigh their own trade-offs.

China’s Fujian is the first Chinese CATOBAR carrier with electromagnetic catapults but conventional propulsion. Open-source estimates compiled by CSIS suggest a build cost in the $6–$9 billion range, with ~80,000 tons displacement. Estimates vary because China does not publish detailed accounts, yet its choice of conventional power and likely lower labor costs imply materially lower unit spend than a U.S. Ford-class.

Why the U.S. spends more is straightforward. Nuclear propulsion, higher sortie-generation targets, and survivability features raise the bill, and the Ford-class includes several first-of-kind systems. CRS notes that while procurement is higher, the Navy expects lifetime O&S savings from automation and design efficiencies compared with Nimitz, partially offsetting the sticker gap. Costs rose fast. Capability rose too.

Lifecycle Cost Beyond Procurement

GAO’s sustainment reviews show O&S dominates lifetime cost for capital warships, with manpower, maintenance, and modernization as primary drivers. For CVN-78, Navy budget data cited by GAO indicate an annual O&S estimate around $391 million once the ship is fully operating, compared with about $490 million for a comparable Nimitz, reflecting targeted savings from automation and layout changes.

Operations and Support also captures air wing effects, pier-side and depot maintenance, and modernization cycles. CRS highlights that Ford-class design changes are intended to reduce total ownership cost versus Nimitz by multiple billions per ship over 50 years, including fewer sailors and more maintainable systems. The Navy’s own public materials have described a lifetime total ownership target near $26.8 billion for CVN-78 in FY04 constant dollars versus $32.1 billion for a Nimitz-class baseline, indicating manpower costs as roughly half of lifetime spend.

Readers often ask about “hidden” lines not obvious in procurement. Those include periodic availabilities, carrier air wing spares, intermediate-level maintenance, consumables, steaming days, and training flight hours. GAO’s methodology sections and program-level tables lay out how crew salaries, depot inductions, modernization insertions, and obsolescence management roll into O&S, which is why two carriers with similar purchase price can diverge meaningfully in lifetime cost share depending on crew size and modernization intensity.

Finally, recapitalization events matter. Mid-life Refueling and Complex Overhaul on nuclear carriers is a multibillion-dollar milestone, with historical Nimitz-class RCOHs reported in the $2.1–$2.6 billion range in then-year dollars for major hulls. That is a planned, budgeted event, but it underscores why procurement dollars understate what taxpayers ultimately finance over five decades.

Economic and Industrial Base Angle

Carrier building sustains a unique industrial base. Newport News Shipbuilding in Virginia is the sole U.S. nuclear carrier yard, employing about 25,000 people directly at the site, with HII reporting nationwide supplier networks that extend across dozens of states. This concentration of skills is strategic and deliberate, as it protects nuclear-qualified trades, design talent, and specialized facilities that cannot be duplicated easily.

The spillovers are broad. Nuclear propulsion work touches reactor component vendors, specialized steel producers, and complex systems integrators. Congressional delegations routinely back steady funding profiles because supplier health suffers when long gaps appear between ships, and restarts are costly. CBO’s 30-year shipbuilding outlook warns that extended pauses increase unit prices by eroding learning curves and workforce experience, reinforcing Navy preferences for multi-ship contracts where possible.

Outsourcing or competing carriers has not been seriously entertained by the Navy. The safety and security demands of nuclear work, the classified nature of many systems, and the sheer capital intensity of a second yard make competition impractical. CRS has long noted the one-yard reality for carriers and submarines, a design of policy rather than accident. It prioritizes assured capacity and quality over theoretical price tension.

Controversies and Criticisms

US Navy Aircraft CarrierNew tech brought growing pains. DOT&E and GAO have documented reliability shortfalls in EMALS and the Advanced Arresting Gear, with early testing showing lower-than-desired mean cycles between failure and a need for hardware and software fixes. Those findings explain why CVN-78’s early deployments carried watchful oversight on sortie-generation claims, even as metrics improved with operational use.

Strategists argue both sides of the carrier debate. Critics point to the concentration of value in a single hull and to anti-ship missile threats, warning that billion-dollar ships are “too expensive to risk,” while proponents cite unmatched power projection, mobility, and sustained air operations that no alternative replicates. CBO’s shipbuilding assessments add a fiscal angle, noting that rising carrier and submarine costs could crowd out other priorities if budgets flatten.

Alternatives surface regularly. Analysts propose more, smaller aviation ships, or drone-forward sea bases, trading capacity and survivability for lower unit costs. Even sympathetic treatments acknowledge trade-offs in speed, sortie rate, and sea state limits. In practice, Congress and the Navy continue to fund Ford-class procurement while exploring complementary unmanned systems, reflecting a hedged approach that addresses both cost pressure and mission demands.

Real-World Comparison Table

Below is a concise, sourced comparison of headline construction and mid-life costs. These are procurement-era figures and do not include air wings, escorts, or routine operations.

Class / Ship (country) Unit construction cost Mid-life refuel or major life-extension
Gerald R. Ford class CVN (US) $12–13+ billion per ship $2.8–$3.0+ billion RCOH (illustrative from CVN-73)
Nimitz class CVN (US) ~$8–$10+ billion late-program units $2–$3+ billion RCOH
Queen Elizabeth class (UK) £6.2 billion for two ships Not nuclear, no reactor refuel
Charles de Gaulle (France) ~€3 billion construction Nuclear refuel/overhauls periodic

Sources: CRS 2024–2025; HII press releases and RAND studies on RCOH; UK National Audit Office and reporting; contemporary open sources for French program.

Expert Insights & Tips

CRS’s recurring assessment frames the Ford program as a trade: higher upfront non-recurring engineering for reduced crew and about $4 billion in 50-year operating and support savings per ship compared with Nimitz. That is a genuine structural benefit when measured over multiple hulls.

CBO’s 2025 shipbuilding plan analysis cautions that budget presentations can understate total ownership if refuelings and certain post-delivery items sit outside the main line, which encourages program managers to present a dual view, one for procurement dollars and one for life-cycle dollars.

GAO’s test reporting shows that aggressive concurrency between construction and new systems tends to push risk into the fleet introduction period, where fixes still cost real money, only later in the schedule. Quiet, mature tech insertion on follow-on hulls is often cheaper.

Finally, dual-ship procurement and yard infrastructure upgrades can pay for themselves in learning effects and avoided idle workforce time, an industrial-base reality backed by the Navy’s 2019 two-ship deal.

Total Cost of Ownership

A straightforward worked example helps. Take a follow-on Ford-class unit at $12.3–$13.2 billion for procurement. Add a mid-life RCOH in the $2.8–$3.0+ billion range based on recent contracts. That alone yields ~$15–$16 billion for construction and refueling across five decades before counting annual operations, modernizations, and the air wing and escorts that turn a ship into a carrier strike group. CRS adds that the Ford design’s reduced crew targets about $4 billion lower operating and support cost over life than a Nimitz, an important offset that still does not eliminate the need to budget billions more for modernization, depot availabilities, and pier and dry-dock upgrades over time.

Hidden costs most people miss

  • Carrier air wing procurement and upgrades are outside the ship price and can total multiple billions across the aircraft’s life cycles.
  • Escort and logistics ships are budgeted separately.
  • Weapons, spares, and training systems appear in other accounts.
  • Pier, dry-dock, and base improvements are capital projects not shown in the hull line

Answers to Common Questions

Does the ship price include the aircraft. No, the air wing is funded separately and not included in the carrier’s procurement cap.

Why did the first Ford-class ship run over early caps. New systems like EMALS and AAG required extra development and testing, pushing cost and schedule beyond initial assumptions for the lead unit.

How do two-ship contracts save money. Buying in bulk lets the yard and vendors plan longer runs, share tooling, and level the workforce, which the Navy estimated saved $3–$4 billion across CVN-80 and CVN-81.

What do allies’ carriers cost. The UK built two Queen Elizabeth-class carriers for £6.2 billion total, and France’s Charles de Gaulle was about €3 billion to build in 1990s euros, both smaller than US CVNs and with different propulsion and air operations.

What is the single best way to lower unit cost. Stabilize the build cadence and lock multi-ship buys as early as design allows, then avoid introducing unproven technologies on the first hull.

Sources used in this piece include Congressional Research Service updates through January 2025, GAO testing reports, Navy and shipbuilder releases, the US Navy’s 2019 two-ship press statement, and CBO’s 2025 shipbuilding analysis
